Unique Well Design Challenge for Conductor String in North Sea

Centek /29th September 2025/ OFFSHORE

In this project for a Norwegian operator, a challenging North Sea well required a 26" hinged centralizer capable of passing through a 30" wellhead restriction and then expanding to function in a 32" open hole — a configuration that standard solutions could not handle. Centek’s engineers created a bespoke hinged TUR centralizer, using in-house modeling and testing to validate the design. The final product was deployed on 24 conductor strings. In the first run, all seven conductors reached depth with no run-in-hole issues, no drag or hang-up, and full centralizer deployment, confirming the design’s effectiveness even in restricted zones.

Centek’s bespoke hinged TUR centralizer successfully met a complex North Sea conductor challenge, passing through tight restrictions and delivering flawless run-in-hole performance.

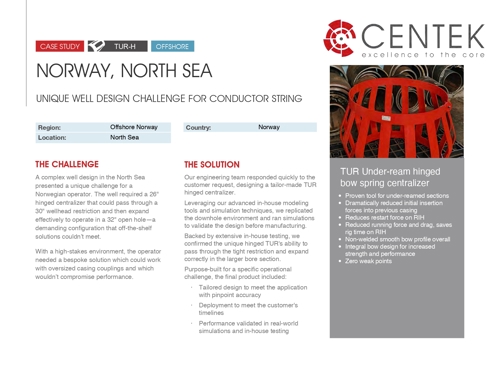

THE CHALLENGE

A complex well design in the North Sea presented a unique challenge for a Norwegian operator. The well required a 26" hinged centralizer that could pass through a 30" wellhead restriction and then expand effectively to operate in a 32" open hole—a demanding configuration that off-the-shelf solutions couldn’t meet. With a high-stakes environment, the operator needed a bespoke solution which could work with oversized casing couplings and which wouldn’t compromise performance.

THE SOLUTION

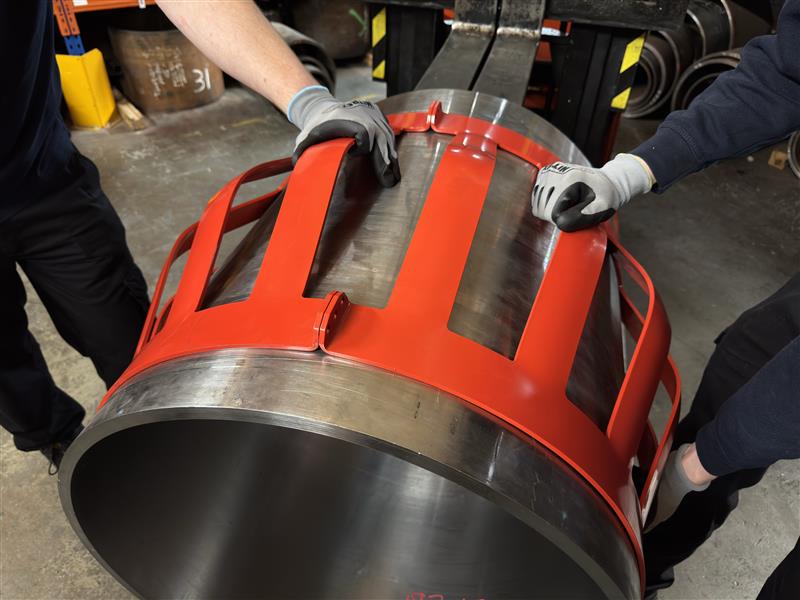

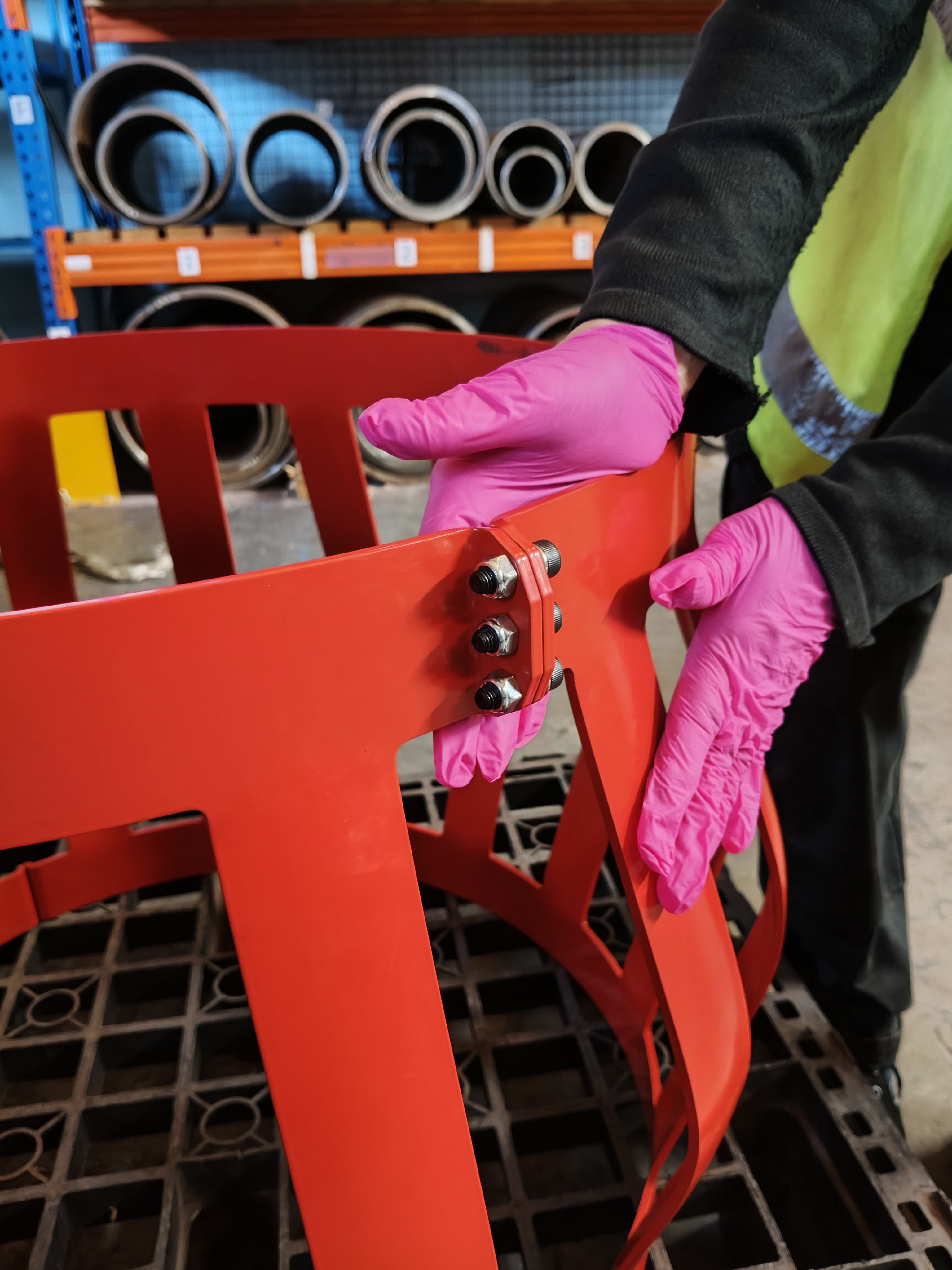

Our engineering team responded quickly to the customer request, designing a tailor-made TUR hinged centralizer. Leveraging our advanced in-house modeling tools and simulation techniques, we replicated the downhole environment and ran simulations to validate the design before manufacturing. Backed by extensive in-house testing, we confirmed the unique hinged TUR's ability to pass through the tight restriction and expand correctly in the larger bore section. Purpose-built for a specific operational challenge, the final product included:

  • Tailored design to meet the application with pinpoint accuracy
  • Deployment to meet the customer's timelines
  • Performance validated in real-world simulations and in-house testing

THE RESULT

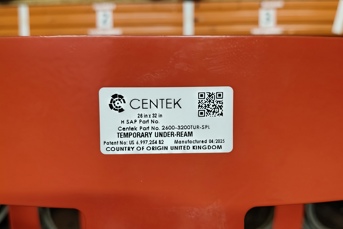

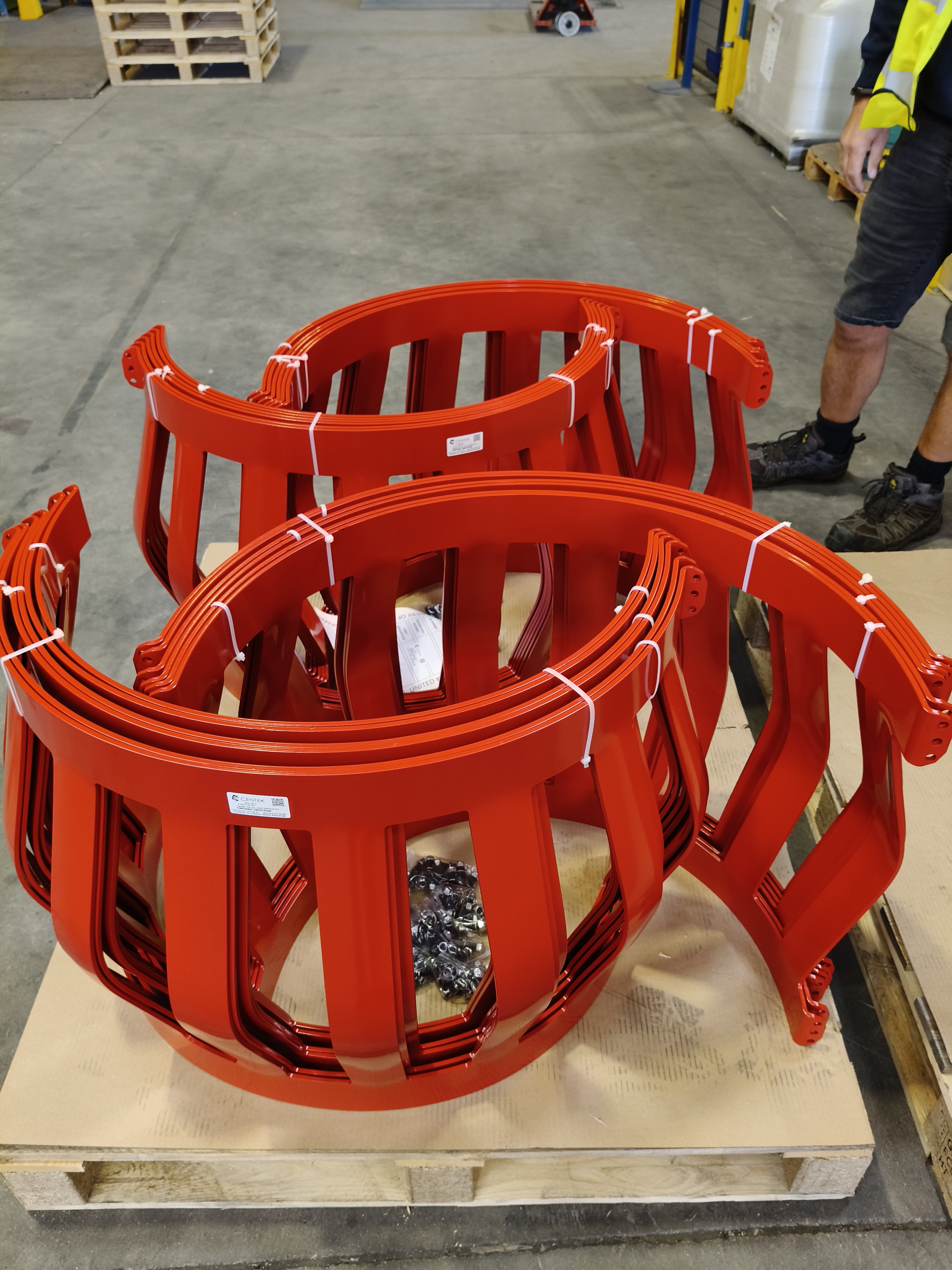

Since development, the centralizers were installed on 24 conductor strings.

During the first job, the operator suspected a tight hole near TD and initially removed the bottom two centralizers as a precaution. After review, the customer decided to reinstall them and proceeded with the run.

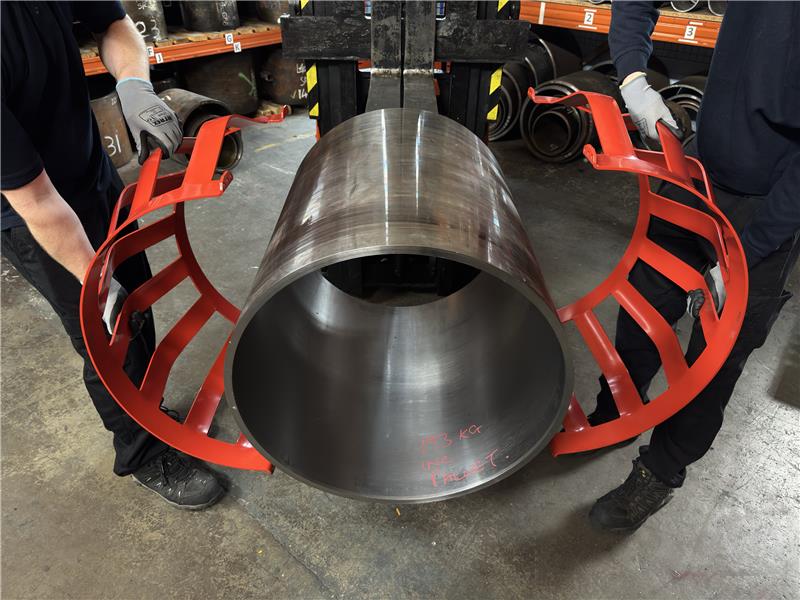

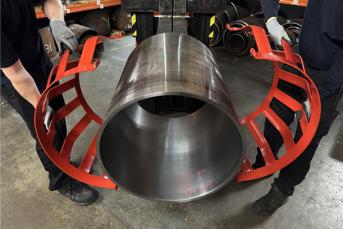

All seven conductors were successfully run to depth with no RIH (run-in-hole) issues. Centralizers performed as expected with no signs of drag, hang-up, or tight hole complications. The trial confirmed that even with concern for a restricted section, keeping the full complement of centralizers in place ensured consistent, safe casing running. The use of 26″ centralizers on conductor casing has proven effective and trouble-free across multiple runs.

Operator noted no issues with centralization or RIH, reinforcing confidence in the design for large-diameter, near-surface applications. This case study demonstrates Centek’s ability to solve complex downhole challenges, without compromising quality or performance.

Get the complete story

Download Full Case Study
TUR Large Image (1)

Flexible with Low Start and Running Forces

The Centek TUR bow spring centralizer is engineered for use in close tolerance, under-reamed applications commonly found in some of the world’s most challenging offshore fields.
